Stories like this play out on jobsites across the country every day. According to an AGC survey of 2,136 contractors, 75% reported project delays from material shortages or longer lead times, and 57% experienced delivery delays outright. The Construction Industry Institute reports that materials account for 50%–60% of total project cost — meaning the stakes for managing them poorly are enormous.
This guide covers the full picture: the 5 R's framework, each stage of the materials management lifecycle, the most common failure points, and how freight logistics connects the whole system.
Key Takeaways
- Materials represent 50%–60% of total capital project costs, making materials management one of the highest-leverage functions in construction
- The 5 R's (Right Materials, Right Time, Right Quantity, Right Price, Right Sources) form the core decision framework for all procurement choices
- Poor material readiness adds 16%–18% to craft labor hours, per CII research
- Centralized procurement, just-in-time delivery coordination, and digital tracking consistently drive the strongest improvements in project outcomes
- Freight logistics — carrier selection, transit routing, and real-time tracking — bridges procurement decisions and on-site execution
The 5 R's of Construction Materials Management
The 5 R's aren't an official PMI or AACE standard — they're a practical organizing framework that experienced project teams use to evaluate every procurement and logistics decision. If a choice fails any one of these five criteria, it's the wrong choice.
Right Materials
"Right materials" means sourcing items that meet the project's exact engineering specifications, quality standards, and applicable building codes. Not the cheapest available option, not a close substitute unless formally approved through a change process. Specification compliance protects the project from costly rework and potential safety failures down the line.
Right Time
Every material needs a Required On-Site (ROS) date — a specific window coordinated with the construction phase that needs it. Both timing failures carry real costs:
- Too late: Crews sit idle, schedules slip, and downstream activities cascade
- Too early: Storage problems, damage risk, and jobsite congestion pile up before materials are even needed
Right Quantity
The balance here is unforgiving in both directions:
- Excess inventory: Storage costs climb, materials face damage exposure, and surplus becomes a disposal problem
- Insufficient stock: Work stoppages, emergency orders, and schedule cascades ripple into downstream activities
Accurate quantity forecasting — based on detailed takeoffs and updated as designs evolve — is what keeps you out of both traps.
Right Price
Right price isn't simply the lowest bid. Strategic procurement means:
- Soliciting multiple supplier quotes before committing
- Locking in rates for commodity materials prone to price volatility (steel, lumber, copper)
- Negotiating bulk pricing where storage and cash flow allow
- Avoiding rush-order premiums through proper advance planning

Right Sources
An Approved Manufacturers/Suppliers List (AML) is the foundation here. It documents vetted vendors with a track record of quality and reliable delivery. The AML only stays useful if it's maintained. Tracking ongoing vendor performance — on-time delivery rates, partial delivery history, quality reject rates — gives procurement teams the data to make smarter decisions on future projects. Those relationships also matter when supply is tight and vendors choose which customers to prioritize.

Key Stages of the Construction Materials Management Process

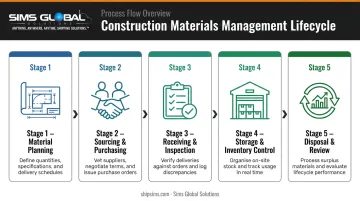

Materials management isn't a single activity — it's a connected lifecycle that runs from early project planning through final site cleanup. Each stage feeds the next, and a breakdown at any point creates problems that compound downstream.
Material Planning and Requirements
This stage happens during engineering, not after it. Procurement teams collaborate with engineers to generate material lists directly from design documents — P&IDs, blueprints, plan views — and group items by commodity type to organize requisition planning. Each item then gets back-planned against its ROS date so procurement timelines are anchored to actual construction sequences, not arbitrary estimates.
Sourcing, Purchasing, and Supplier Selection
Once requirements are defined, the team issues Requests for Proposals (RFPs) and evaluates bids based on more than price. Supplier history matters, including:
- Past on-time delivery rates and how partial deliveries were handled
- Quality record and financial stability
- Responsiveness during disputes or delays
Purchase orders should include delivery schedules, inspection requirements, and escalation clauses for price-volatile materials — not just quantities and costs.
Receiving, Inspection, and Quality Control
Every incoming shipment needs to be verified before it's accepted. AISC 207-25 provides a useful model: compare received materials against purchase-order requirements, confirm quantities, identify the material, and check for visible shipping damage. Non-conforming materials should be flagged immediately — before installation, not after. Accepting defective materials and installing them creates rework costs that dwarf the original material value.
Document everything in the inventory system at receipt. Gaps here surface later as audit failures, budget overruns, or unplanned material shortages — all avoidable with accurate intake records.
Storage, Inventory Control, and Issuing
Good storage is organized, labeled, and planned by material type. Steel needs different handling and protection than electrical components or finish materials.
Each storage area should have a documented location system so crews can find materials quickly when needed. Inventory control tracks what's on hand, what's been issued, and what's pending delivery — in real time, not from memory.
Issuing materials to crews on a tracked basis also creates accountability. It's how you catch material cannibalism early: the practice of pulling materials designated for one work activity and redirecting them to another, which throws sequencing and budgets off track.
Material Disposal and Post-Project Review

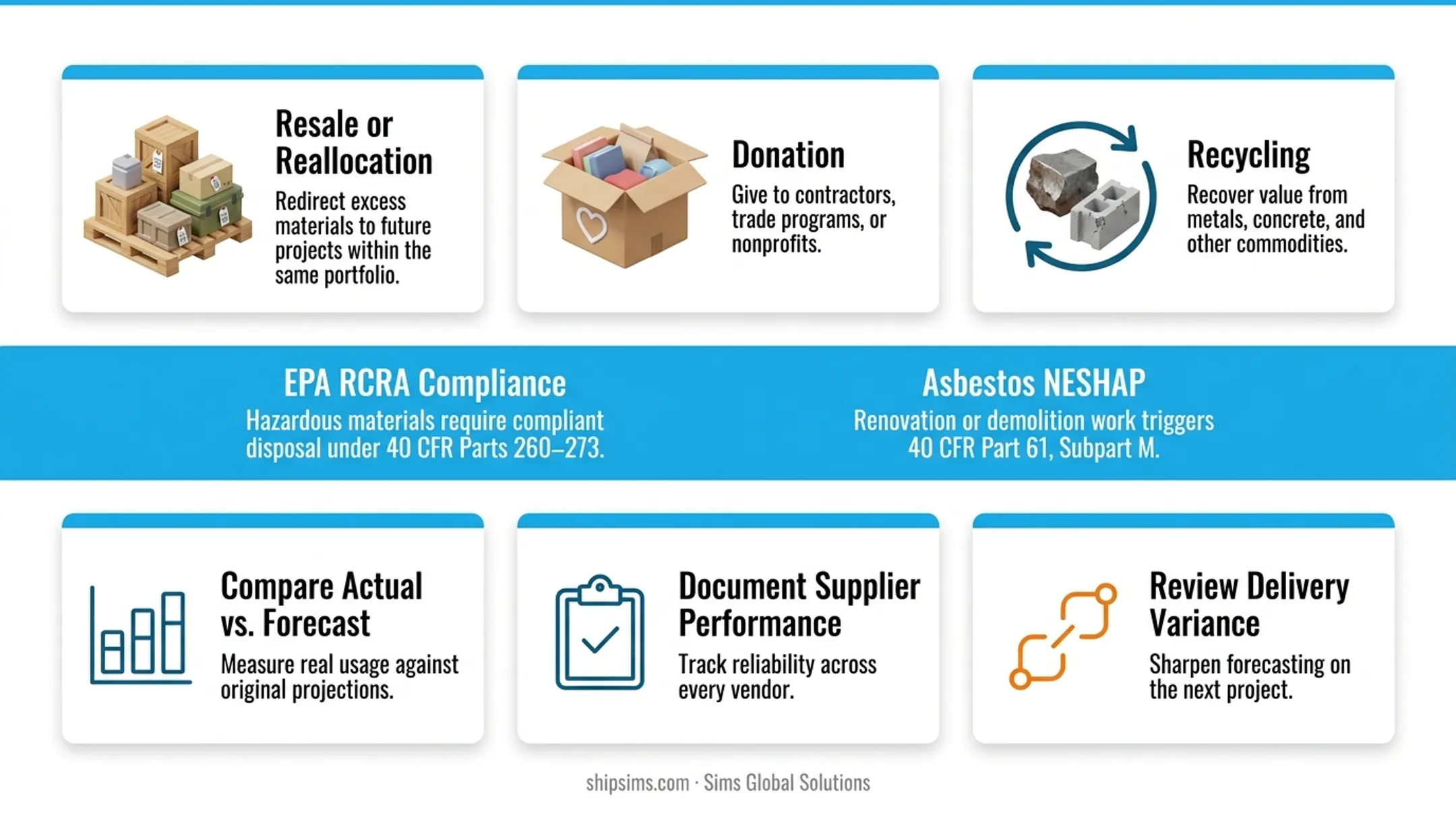

Excess materials at project closeout have real options:
- Resale or reallocation to future projects within the same portfolio
- Donation to contractors, trade programs, or nonprofits
- Recycling for metals, concrete, and other commodities with recovery value
Hazardous materials require compliant disposal under EPA RCRA regulations (40 CFR Parts 260–273), and renovation or demolition work involving asbestos triggers specific requirements under 40 CFR Part 61, Subpart M.
The post-project review is often skipped under deadline pressure, but it's where the most actionable data sits. Comparing actual material usage against forecasts, documenting supplier performance, and reviewing delivery variance gives the team a foundation for better forecasting on the next project.

Why Effective Construction Materials Management Matters
CII research puts construction materials at 50%–60% of total project cost — the single largest cost category on most capital projects. When that cost category is managed poorly, the consequences don't stay contained.
The Cost Cascade of Mismanagement

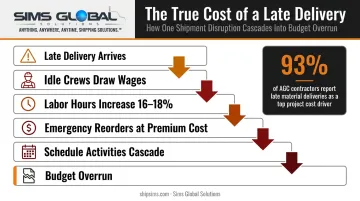

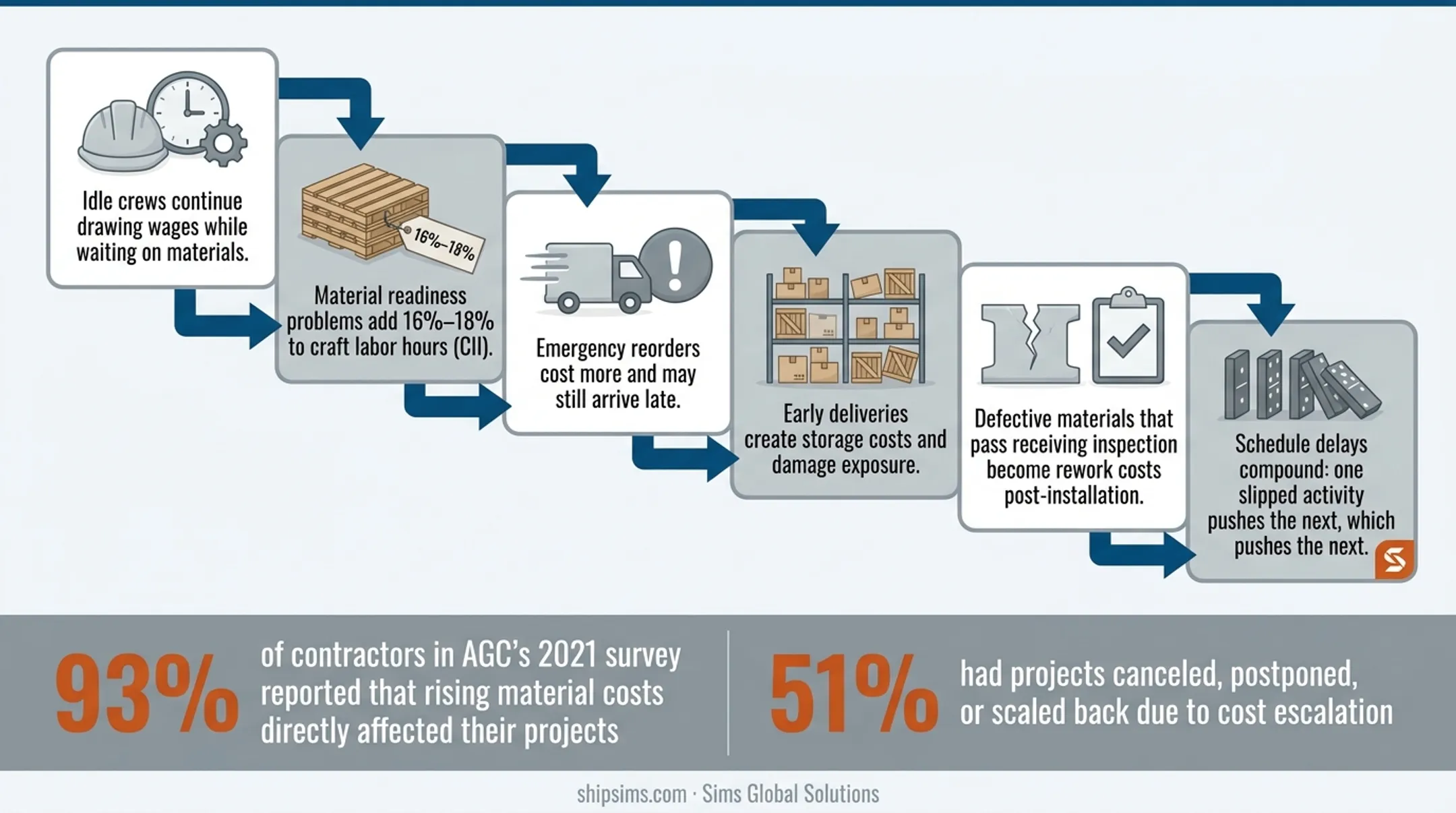

A single late delivery doesn't just delay that day's work. It triggers a chain reaction:
- Idle crews continue drawing wages while waiting on materials
- Material readiness problems add 16%–18% to craft labor hours (CII)
- Emergency reorders cost more and may still arrive late
- Early deliveries create storage costs and damage exposure
- Defective materials that pass receiving inspection become rework costs post-installation
- Schedule delays compound: one slipped activity pushes the next, which pushes the next
93% of contractors in AGC's 2021 survey reported that rising material costs directly affected their projects, and 51% had projects canceled, postponed, or scaled back due to cost escalation.

What Good Management Delivers
The flip side is equally measurable. When materials management works, the results show up across the entire project:
- Reduces emergency orders and surplus disposal through accurate demand forecasting
- Keeps crews on schedule — materials arrive when needed, not days early or late
- Catches defects before installation through systematic receiving inspections
- Cuts surplus and disposal costs with tighter quantity planning
- Lowers site injury risk when materials are stored and handled correctly
- Creates audit-ready documentation — receipts, inventory records, and inspection logs that support claims and future project estimates
Common Challenges in Construction Materials Management
Inaccurate Forecasting
Design changes, weather delays, and shifting project conditions require constant forecast updates — but many teams set their material lists at the start and don't revisit them. Under-ordering stops work; over-ordering creates storage, damage, and disposal costs. Either way, the root cause is the same: treating forecasting as a one-time task rather than an ongoing process.
Supply Chain Complexity and Disruption
Modern construction projects involve multiple subcontractors, dozens of suppliers, and several logistics providers — all moving on different timelines. Lead times for some materials extend months, and suppliers can fail without warning.
In AGC's 2022 survey, only 9% of firms reported no significant supply chain problems, and 70% responded by accelerating purchases after contract award to get ahead of disruptions.
Price volatility adds another layer of risk. Lumber and plywood prices spiked 62% year-over-year in early 2021. Steel, copper, and aluminum continue to move significantly — nonresidential construction inputs rose 3.3% from December 2024 to December 2025, driven by metals tariffs.
On-Site Challenges
Getting materials to the jobsite is only half the battle. On-site execution introduces its own set of problems:
- Limited storage space forces difficult decisions about staging and sequencing
- Material cannibalism — pulling materials from one activity to cover another — creates cascading shortages that are hard to track and harder to recover from
- Improper handling leads to damage, increasing both replacement costs and schedule impact
- Data management burden grows with project scale; large projects may track thousands of line items across dozens of suppliers
Best Practices for Managing Construction Materials
Maintain Live Forecasts
An outdated material forecast gives you false confidence. Run regular inventory checks, compare actuals against planned schedules weekly or monthly, and update forecasts whenever design changes or schedule shifts occur. For price-volatile commodities, monitor market conditions actively and lock in rates before they move.
Centralize Procurement
Decentralized purchasing — where subcontractors and site managers each order independently — creates duplicated costs, inconsistent quality, and no consolidated visibility. Centralized procurement with an approved vendor list, standardized purchase order templates, and long-term supplier contracts reduces ad hoc purchasing and the errors that come with it.
Align Deliveries to the Schedule
Just-in-time delivery, where practical, keeps storage requirements manageable and materials in better condition. This requires close coordination between the materials manager and the construction schedule — ROS dates need to be maintained and communicated to suppliers and logistics partners, not just filed away.
On-site storage should use:
- Clearly labeled, designated areas for each material type
- Documented location records so materials can be found quickly
- Preservation plans based on manufacturer requirements (some materials degrade rapidly without proper storage conditions)
Enforce Handling Protocols
Crew training on lift requirements, weight limits, and proper equipment use directly determines whether materials arrive at installation in specification or arrive damaged. Assign on-site managers to enforce handling procedures, especially for heavy, oversized, or fragile materials.
Use Digital Tracking Tools

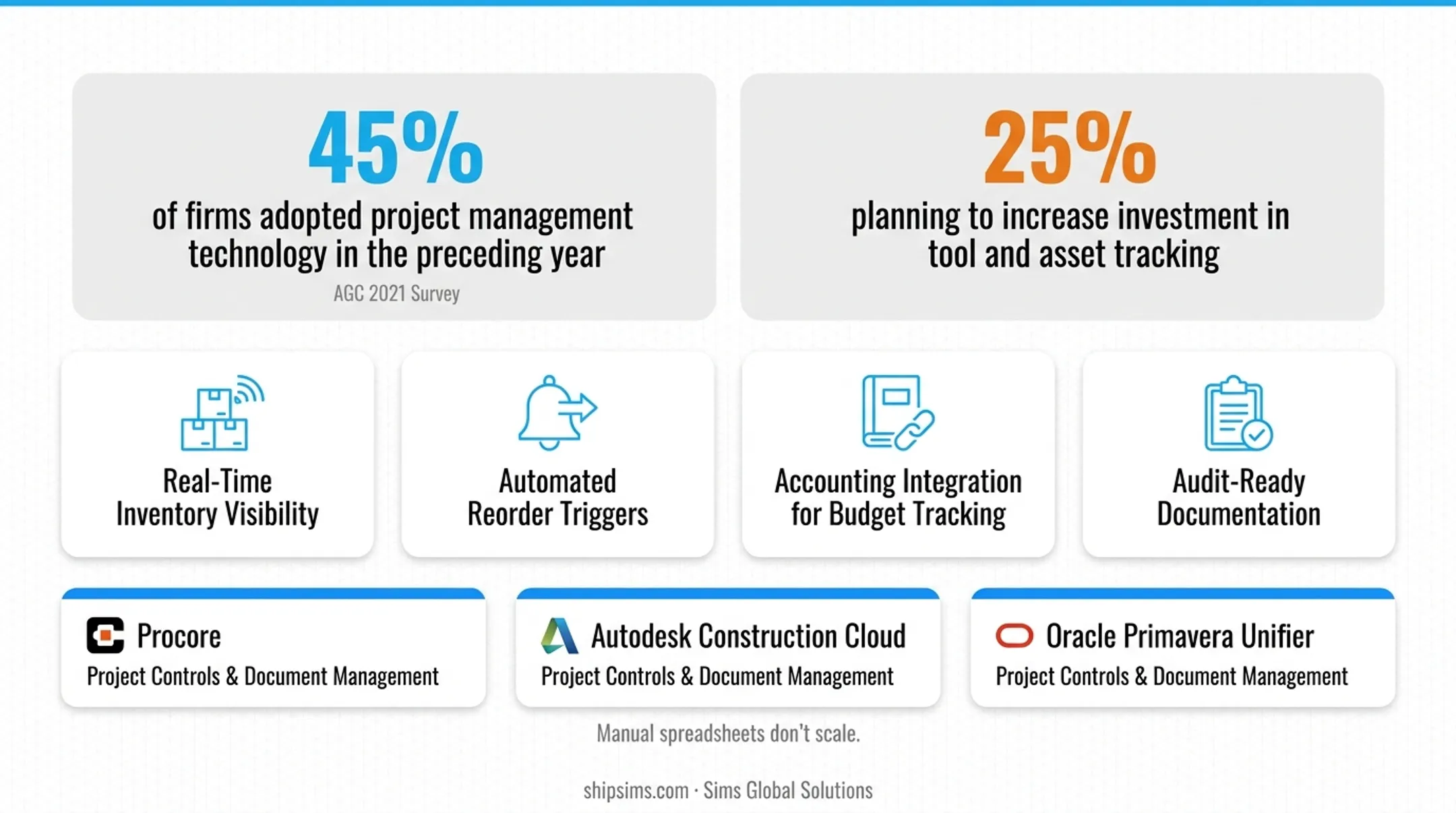

Construction materials management software provides real-time inventory visibility, automates reorder triggers when stock falls below threshold, integrates with accounting systems for budget tracking, and creates audit-ready documentation throughout the project lifecycle. AGC's 2021 survey found 45% of firms had adopted project management technology in the preceding year — with another 25% planning to increase investment in tool and asset tracking.
Platforms like Procore, Autodesk Construction Cloud, and Oracle Primavera Unifier each offer project controls and document management capabilities relevant to materials tracking. The right tool depends on project scale and existing systems, but the principle is consistent: manual spreadsheets don't scale, and the cost of poor data visibility shows up in emergency orders and budget surprises.

The Role of Freight Logistics in Construction Materials Management
The best procurement plan in the world still fails if materials can't get to the jobsite reliably. Freight logistics — carrier selection, transit routing, expediting, and shipment tracking — is the connective tissue between purchase orders and installed materials.

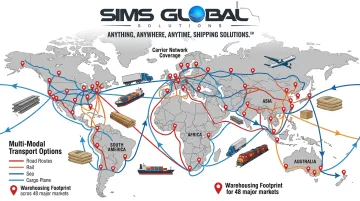

Multi-Modal Matters
Construction materials don't all ship the same way. Steel beams require flatbed or heavy haul equipment. Electrical components move efficiently via LTL. Time-critical items need expedited service. Oversized equipment may require over-dimensional permitting and route surveys. A logistics partner that can handle all of these modes — without requiring the construction team to manage separate carriers for each — reduces coordination overhead considerably.

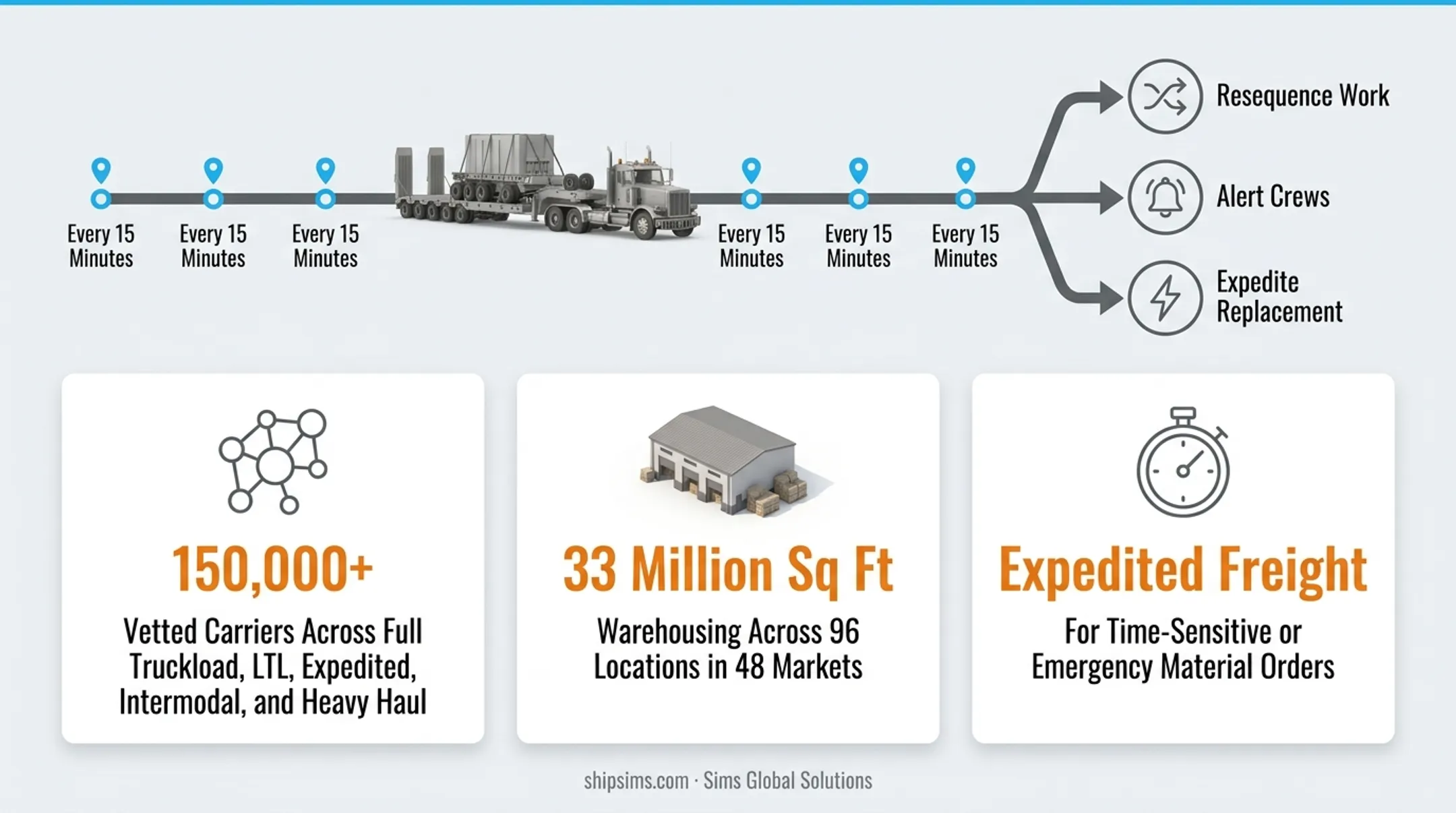

Real-Time Visibility Changes the Response Time
When a shipment runs late, the question isn't whether it will affect the schedule — it's how quickly the project manager can respond. Real-time GPS tracking gives construction teams the visibility to make proactive decisions: resequencing work, alerting crews, or expediting a replacement before a single day is lost.
Sims Global Solutions addresses this directly. Their SimsTrak TMS delivers automated GPS location updates every 15 minutes, giving project managers the visibility to coordinate deliveries with active construction phases rather than reacting after delays have already hit the schedule.
For construction teams managing complex material flows, Sims offers:
- Access to 150,000+ vetted carriers across full truckload, LTL, expedited, intermodal, and heavy haul modes
- Expedited freight options for time-sensitive or emergency material orders
- 33 million square feet of warehousing across 96 locations in 48 markets for staging when jobsite storage is constrained

Freight isn't an afterthought. It's the last mile between a well-managed procurement process and materials actually in the hands of the crew that needs them.
Frequently Asked Questions
How do you manage materials on a construction site?
Designate clearly labeled storage areas for each material type, track inventory with a digital system, and align delivery windows to the construction schedule using ROS dates. Implement handling protocols — trained crews, proper equipment, assigned managers — to prevent damage and theft.
What are the responsibilities of a material manager in construction?
A materials manager oversees procurement, delivery coordination, storage, inventory tracking, and distribution for all project materials. They collaborate with engineering, procurement, and construction teams to ensure the right materials arrive on time, in spec, and within budget.
What are the 5 R's of material management?
The five R's cover Right Materials, Right Time, Right Quantity, Right Price, and Right Sources. Together, these criteria guide every procurement and logistics decision on a construction project.
What are the five major areas of materials management?
Materials planning, sourcing and purchasing, inventory control and storage, material handling and distribution, and disposal or surplus management. Each area feeds into the next across the project lifecycle.
What is the difference between construction materials management and supply chain management?
Supply chain management oversees the broader flow of goods across an entire organization or multiple projects. Materials management focuses specifically on the procurement, tracking, and distribution of materials for individual construction projects, working at a more granular, day-to-day level.
