A poorly executed move can mean costly downtime, data loss, or compliance exposure. According to Uptime Institute's 2022 Outage Analysis, more than 60% of data center failures produced at least $100,000 in total losses — and that share reaching $1 million or more rose to 15% in 2022. The stakes are real.
This guide is written for IT managers, infrastructure leads, and operations teams evaluating or planning a move. It covers what data center moving actually involves, why organizations do it, how the process works step by step, and where projects most commonly go wrong.
Key Takeaways
- Data center moving transfers physical IT assets (servers, storage, networking gear) from one facility or environment to another
- Moves are triggered by lease expirations, capacity constraints, cost pressures, or strategic shifts like colocation adoption
- The full process — planning through post-move testing — typically takes six months to over a year
- Server hardware and IT equipment require specialized carriers, not standard freight
- Most failures trace back to inadequate planning and skipped testing, not the transport itself
What Is Data Center Moving?
Data center moving refers to the transfer of IT assets — servers, storage devices, networking equipment, and racks — from one facility or environment to another. It can be complete (full relocation) or partial (moving a subset of infrastructure while leaving the rest in place).
The scope varies significantly depending on the situation:
- Floor-to-floor moves within the same building
- Facility-to-facility relocations across cities or regions
- On-premise to colocation transfers, where infrastructure moves to a shared facility
- Physical-to-virtual migrations, where hardware workloads shift to cloud environments
Relocation vs. Migration: What's the Difference?
These terms get used interchangeably, but the distinction matters when scoping a project.
Relocation refers specifically to the physical movement of infrastructure from one location to another. It involves logistics planning, transport, and physical reinstallation.
Migration is broader: it covers transfers of data, applications, and workloads to new platforms, and doesn't necessarily involve moving any physical hardware. A cloud migration, for example, is purely virtual.
The distinction has real project implications. Physical relocations require logistics coordination, carrier selection, and hardware handling protocols that virtual migrations don't. IT teams that conflate the two often discover mid-project that they've underfunded the physical component — sometimes by a significant margin.
Why IT Teams Move Data Centers
Moves are rarely optional. They tend to be driven by a convergence of pressures rather than a single trigger.
Common business drivers include:
- Lease expiration — the most common forcing function, with a fixed, non-negotiable timeline
- Capacity limits — insufficient power, cooling, or physical space to support growth
- Cost pressure — colocation facilities often deliver better PUE and operational efficiency than aging on-premise environments
- Geographic strategy — relocating closer to users, network hubs, or lower-cost power markets
- Compliance requirements — certain data must reside in specific jurisdictions or certified facility types

The infrastructure age issue is documented. Uptime Institute's 2025 Global Data Center Survey found that 27.5% of respondents work in facilities at least 16 years old, with average PUE of 1.54 — virtually unchanged for six years. Older facilities consume more energy, require more maintenance, and increasingly fall short of modern workload requirements.
Those aging environments carry compounding risk. Organizations that delay a necessary move face rising operating costs, security vulnerabilities in legacy infrastructure, and growing exposure to regulatory penalties — pressures that typically intensify each year the move is deferred.
How Data Center Moving Works: A Step-by-Step Process
A data center move is a structured, multi-phase project that touches planning, asset management, logistics, reconfiguration, and validation. For large environments, it typically spans several months to over a year. Rushing any phase creates risk downstream.
Step 1: Planning and Scoping
Planning is the phase that determines whether everything else succeeds or fails. It involves:
- Defining scope (partial vs. full move, physical vs. virtual components)
- Setting realistic timelines and budgets with contingency built in
- Assigning a dedicated technical project manager
- Getting stakeholder alignment across IT leadership and affected business units
- Documenting contingency plans for equipment damage, transit delays, and extended downtime
Teams that skip formal planning typically surface those gaps during transport or post-installation testing — the two moments when fixing them is most expensive.
Step 2: Asset Audit and Inventory
Before anything is moved, teams need a complete picture of what exists. This means:
- Full hardware inventory — every server, switch, storage array, rack, and cable
- Dependency mapping — which systems depend on which, and in what order they must come back online
- Mission-critical classification — identifying which assets cannot tolerate extended downtime
- Disposition decisions — determining what gets relocated, what gets upgraded, and what gets decommissioned rather than moved
This is where a CMDB-style inventory pays off. Organizations that skip this step routinely discover undocumented interdependencies during post-move testing, which can push recovery timelines out by days.
Step 3: Physical Transport and Logistics
Moving server racks, storage arrays, and networking gear is not standard freight. The equipment is heavy, sensitive to shock and electrostatic discharge, and requires carriers with specific experience in technology logistics.

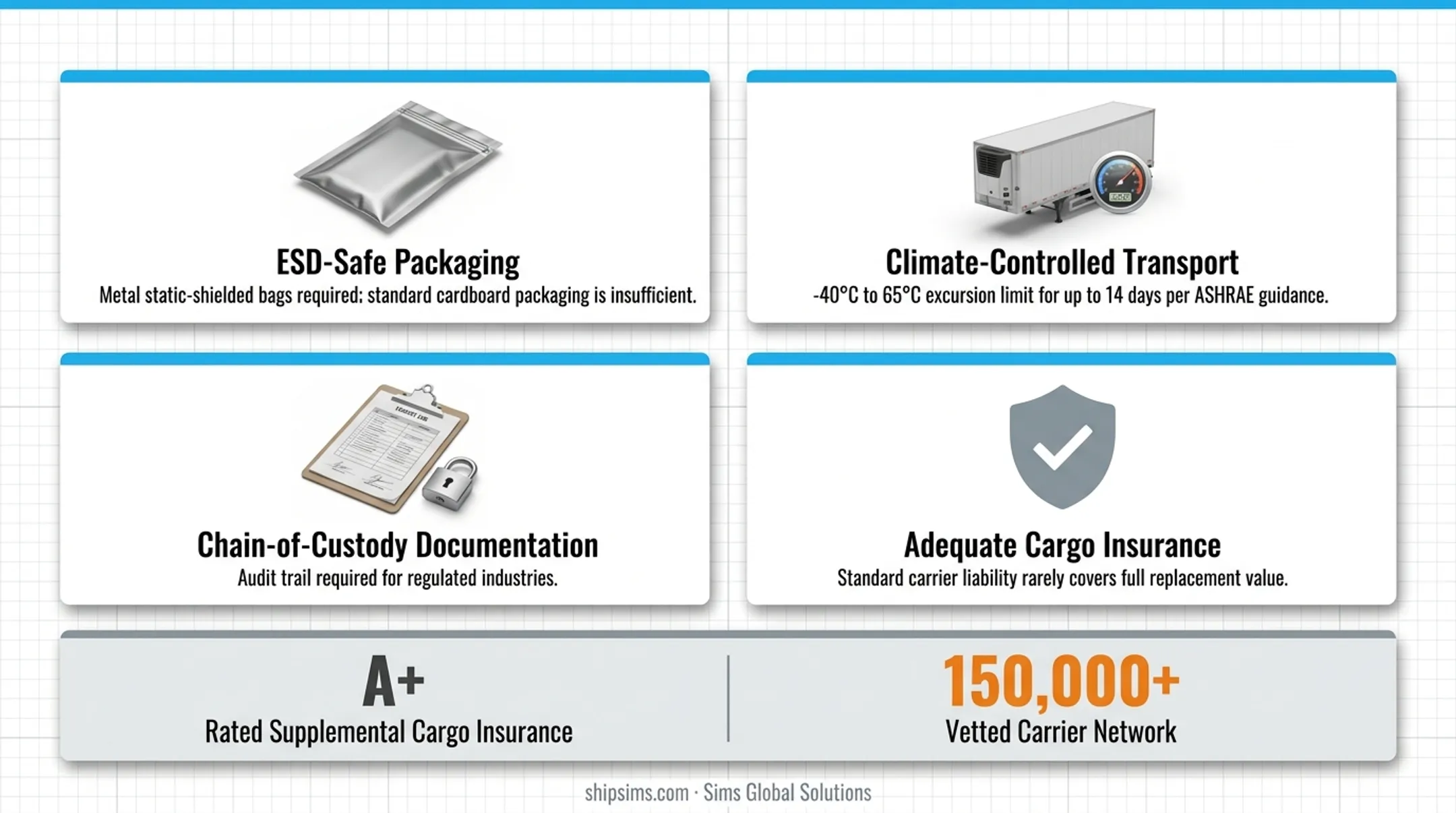

Key requirements for data center transport:
- ESD-safe packaging — Dell's guidance requires static-sensitive devices to be shipped in metal static-shielded bags; standard cardboard packaging is insufficient
- Climate-controlled transport where equipment specifications require it — ASHRAE's storage guidelines set hard-drive shipping excursion limits of -40°C to 65°C for up to 14 days
- Chain-of-custody documentation — especially for regulated industries where audit trails are required
- Adequate cargo insurance — standard carrier liability rarely covers the replacement value of enterprise IT hardware
Specialized logistics providers like Sims Global Solutions carry A+ rated supplemental cargo insurance and maintain a vetted network of 150,000+ carriers — giving IT teams the coverage and carrier options that standard freight brokers typically can't offer for mission-critical equipment.

Step 4: Reconfiguration and Installation
Once hardware arrives at the new facility, equipment must be racked, cabled, and reconfigured. Power and cooling infrastructure should already be operational before equipment arrives; waiting until after delivery extends downtime unnecessarily.
Critical verification steps at this stage:
- Power and cooling capacity confirmed against actual equipment mix
- Network configurations and IP addressing validated
- Authentication systems and access controls verified
- High-density equipment (GPU clusters, AI infrastructure) checked against power-per-rack availability — JLL notes that densities approaching 70 kW/rack require liquid cooling, which must be planned at the destination before equipment arrives
Step 5: Testing and Validation
Post-installation testing is where hidden problems surface. Teams should verify:
- All systems come back online in the correct sequence
- Application-level functionality is confirmed, not just network connectivity
- Data integrity is validated end-to-end
- Disaster recovery procedures are tested before the move is declared complete
- Issues discovered during transit or reconfiguration are resolved before cutover
This phase catches problems that weren't visible during transport or installation. Compressing it to hit a deadline often converts a manageable issue into a full-blown outage.
Key Factors That Affect a Data Center Move
Several variables directly shape how complex, costly, and time-consuming a move will be:
| Factor | Impact |
|---|---|
| Equipment volume and density | Affects transport costs, timeline, and carrier requirements |
| Destination infrastructure readiness | Gaps in power/cooling are among the most common delay causes |
| Backup and recovery preparedness | Unverified backups are the leading cause of data loss during moves |
| Downtime planning quality | Determines how long affected business units are impacted |
| Regulatory constraints | Affects carrier selection, documentation requirements, and destination facility eligibility |

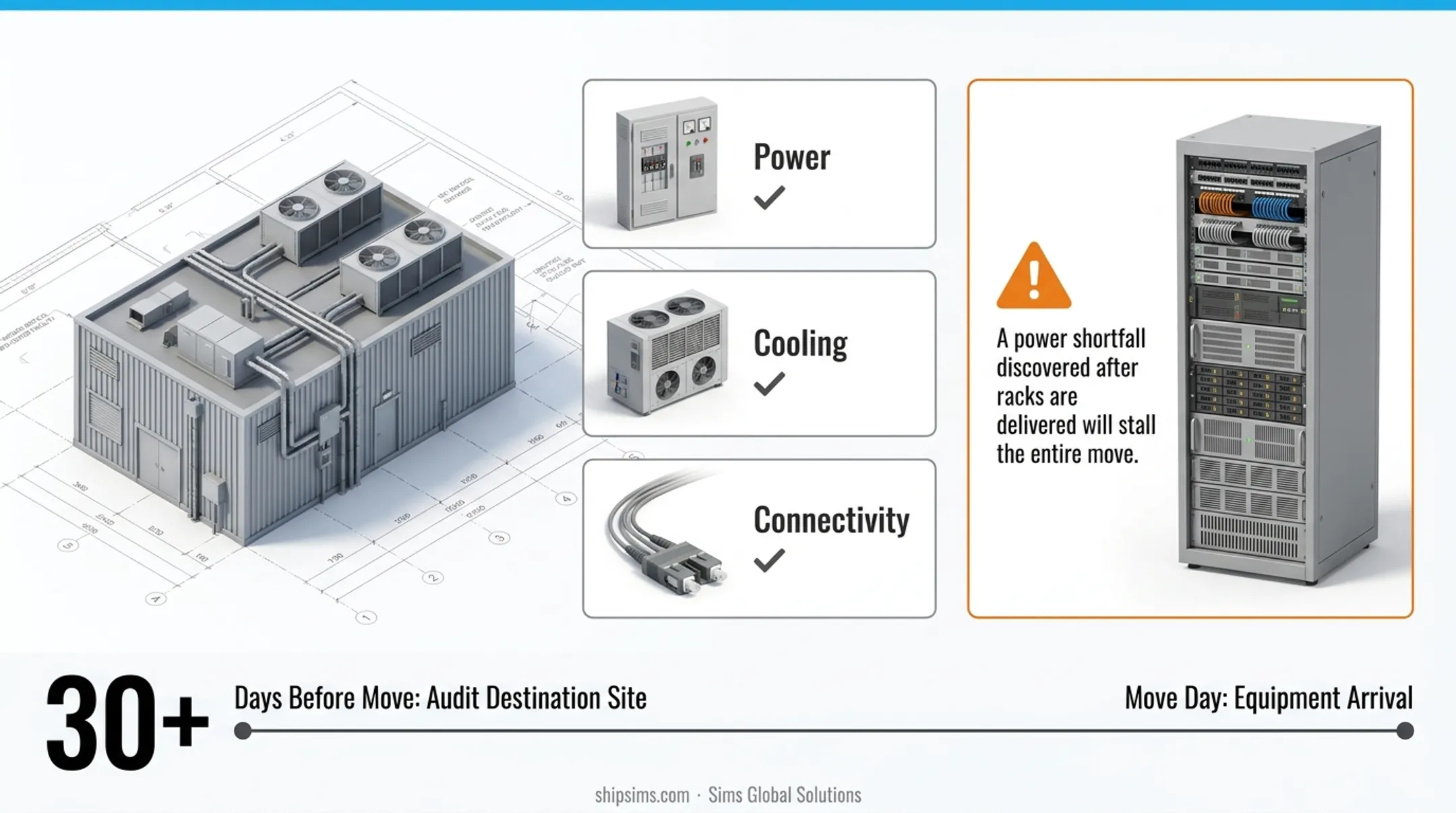

Destination readiness is the most commonly overlooked factor on this list. The new facility must meet power, cooling, and connectivity requirements before equipment arrives — not during installation. A power shortfall discovered after racks are delivered will stall the entire move, regardless of how well the transport and logistics were managed. Audit the destination site at least 30 days before your scheduled move date.
Common Issues and Misconceptions
Three misconceptions consistently derail data center moves — and none of them involve the truck.
"It's primarily a logistics exercise"
The physical transport is one phase of a much longer project. Most failures don't happen during transit — they happen because planning was insufficient, dependencies weren't mapped, or post-move testing was compressed. Freight execution is rarely the bottleneck.
Undocumented dependencies
Legacy applications frequently have interdependencies that were never formally documented. These surface during post-move testing, not during planning. Thorough pre-move inventory and dependency mapping is what catches these before they become outages. An undiscovered dependency can halt recovery for days.
Skipping backup verification
Never assume existing backups are functional without testing them — it's the most dangerous shortcut in any data center move. Acronis's 2022 Cyber Protection Week report found that 76% of organizations experienced downtime due to data loss in the preceding year — and untested backups are a leading contributor. Data loss during a move is most often traced to backups that existed but couldn't be restored, not physical damage to hardware.
When a Data Center Move May Not Be the Right Choice
A full physical relocation isn't always the answer, even when infrastructure problems are real.
A move may be premature if:
- Capacity constraints can be addressed through virtualization or selective cloud migration of specific workloads
- The primary driver is cost, but the destination facility's economics haven't been modeled fully
- Infrastructure issues are localized and can be resolved through targeted hardware upgrades
Signs a move lacks strategic foundation:
- Timelines are compressed without a realistic project plan
- No dedicated project manager has been assigned
- Backup and recovery haven't been tested before the move date
- The budget lacks contingency for delays or extended downtime
Any of these gaps warrant a pause to plan properly — not a cancellation. A rushed move with an underfunded budget typically compounds costs: extended downtime, emergency recovery work, and rescheduled carrier windows add up fast. Taking four extra weeks to prepare almost always costs less than recovering from a move that went wrong.
Conclusion
Data center moving is a structured, multi-phase process that goes well beyond getting equipment from point A to point B. It requires thorough planning, complete asset auditing, physically specialized logistics, destination infrastructure readiness, and thorough post-move testing.
Organizations that treat it as a strategic initiative — with proper resources, experienced logistics partners, and tested contingency plans — avoid the costly downtime and data risks that come from underestimating its complexity. IT teams that partner with logistics providers experienced in mission-critical freight — like Sims Global Solutions — gain the specialized handling, real-time visibility, and contingency coordination that a move of this scale demands.
Frequently Asked Questions
What is the difference between data center relocation and data center migration?
Relocation refers to the physical movement of IT hardware from one facility to another. Migration is broader, covering virtual transfers of data, applications, and workloads — including cloud migrations that involve no physical movement. The two often overlap in practice, but they require different planning considerations and logistics resources.
Where are data centers moving to?
Common destinations include colocation facilities, edge data centers, cloud environments, and regions with lower energy costs and favorable tax incentives. In the US, CBRE's H2 2025 data shows Northern Virginia, Dallas-Fort Worth, Atlanta, Chicago, and Phoenix as the leading markets by total inventory.
Why are data centers moving to Texas?
Texas offers a combination of business-friendly tax incentives — including a 10-year state sales tax exemption for qualifying data centers investing $200M or more — along with available land and proximity to major business hubs. JLL forecasts Texas could become the world's largest data center market by 2030, though power grid demand is growing rapidly alongside that opportunity.
How long does a data center move take?
Timelines vary widely. Small, well-scoped moves may take weeks. Large enterprise relocations routinely take six months to over a year, with planning typically consuming the largest share of that time. Compressed timelines are one of the most reliable predictors of a troubled move.
What are the biggest risks of moving a data center?
The primary risks include:
- Unplanned downtime during cutover
- Data loss from unverified or untested backups
- Physical hardware damage during transport
- Undocumented dependencies that surface during post-move testing
Most are preventable with thorough pre-move planning.
How do I minimize downtime during a data center move?
The most effective approaches are:
- Phase the migration — move non-critical systems first
- Confirm destination infrastructure is fully operational before equipment arrives
- Verify backups are restorable before the move begins
- Work with freight logistics providers experienced in sensitive equipment transport
